For the complete documentation index, see llms.txt. This page is also available as Markdown.

Automatic assignment

Assign downtime reasons by rule instead of contextualising each downtime by hand.

Detected downtimes need a reason so they are booked correctly in the OEE calculation. Doing that by hand for every downtime is impractical across many machines. Automatic assignment applies rules from the availability plan and machine parameters.

Prerequisites

The three tabs

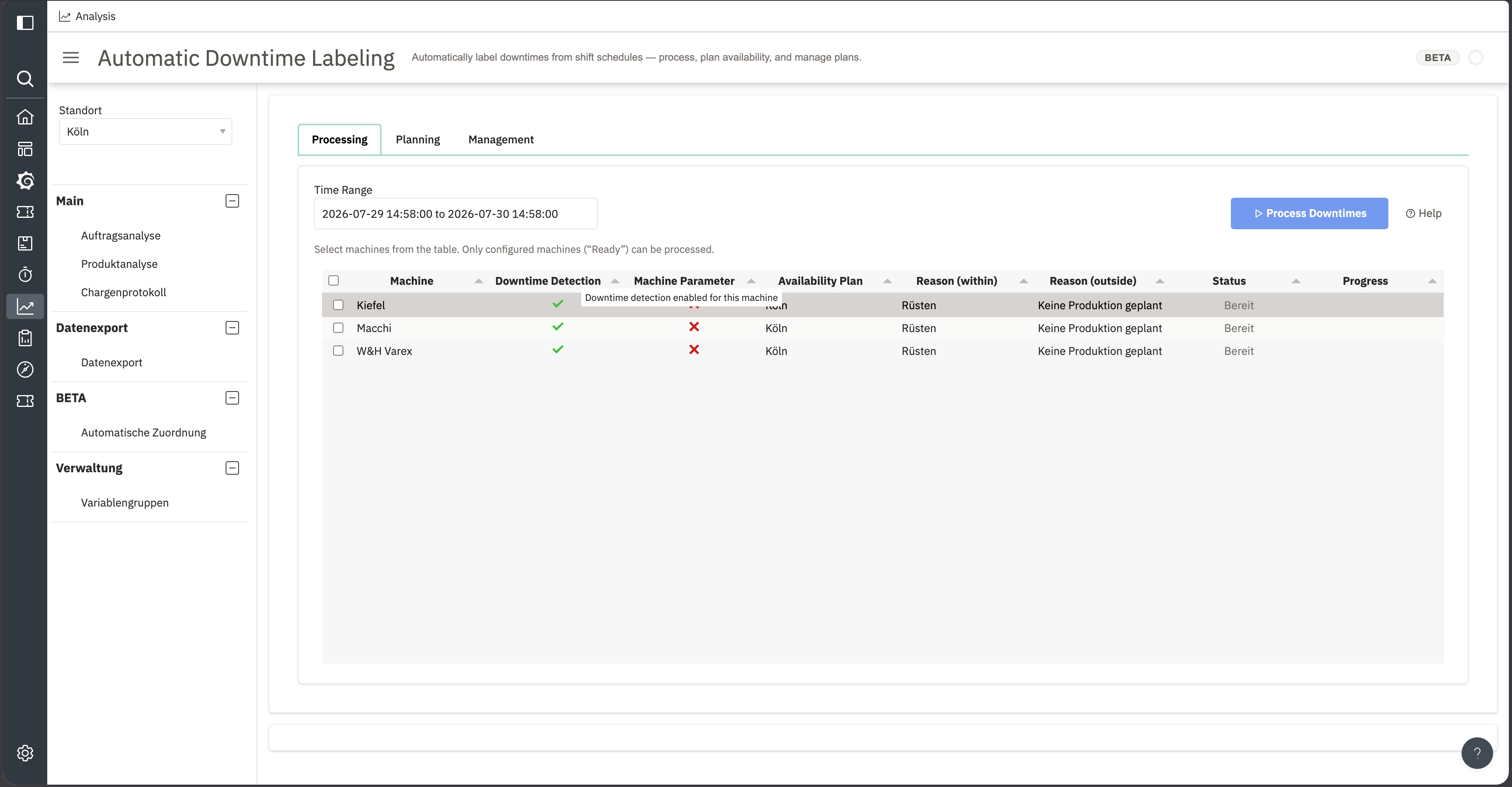

Processing tab with machine table, configuration status and time range selection
The table shows which assignment types are configured per machine
Tab
Purpose

Processing

Run the assignment for machines and a time range

Planning

Maintain shifts and availability plans

Management

Create availability plans, assign machines to them, set default reasons

Processing

The table lists the site's machines with their configuration status:

Column
Meaning

Downtime Detection

Is detection configured for this machine

Machine Parameter

Is machine-parameter assignment configured

Availability plan

Which availability plan applies

Reason (inside)

Default reason for downtimes inside planned time

Reason (outside)

Default reason for downtimes outside planned time

Status

Ready (ready) or Not configured (not configured)

Progress

Progress of the current pass

Only machines showing Ready can be processed. A configured downtime detection is enough for that; machine-parameter assignment is optional and may show a red cross in its column. Select machines in the table, set the Time Range, then select Process Downtimes.

You can process the same range more than once, for example after the availability plan changed.

Assignment by availability plan

The plan splits downtimes into two classes: those inside planned production time, which count as unplanned downtimes, and those outside it, which count as No production planned.

That is not a cosmetic distinction. The No production planned category reduces planned occupancy time, so it is not OEE-relevant. That time does not enter availability. See Availability.

What happens to reasons already assigned

If a downtime already has a reason, its category decides whether the reason survives or is overwritten.

Existing reason
Inside planned time
Outside planned time

no reason assigned

default reason for unplanned downtimes

default reason for no production planned

category No production planned

changed to unplanned

kept

category planned, unplanned or technical problem

kept

changed to no planned working time

Assignment by machine parameters

Alongside the availability plan, reasons can be derived from machine parameters, such as a fault number from the controller.

ENLYZE sets these rules up for you; they are not self-service. The Machine Parameter column in the Processing tab shows whether they are active for a machine. Talk to your Customer Success Manager if you want to use them.

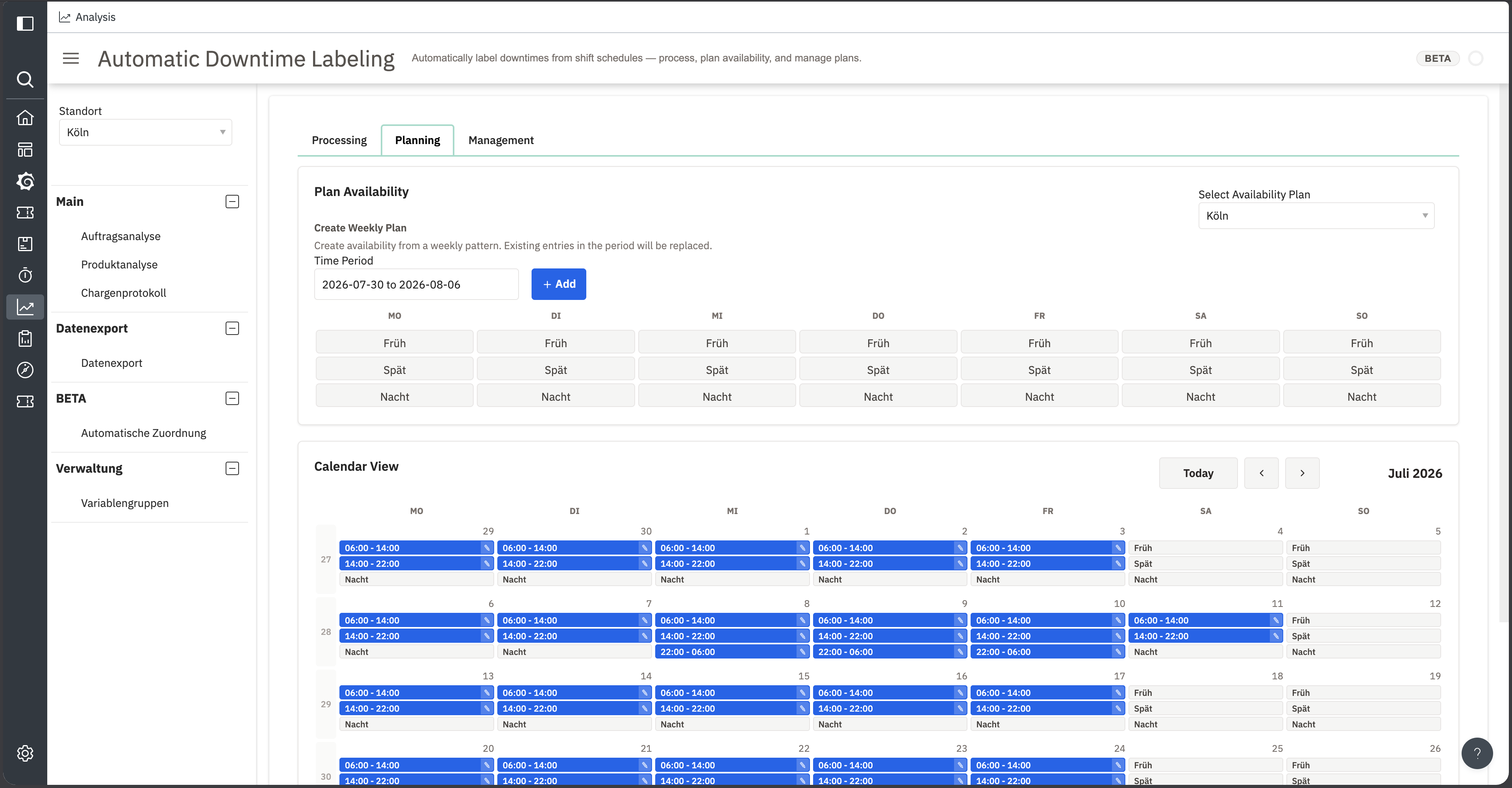

Planning

Planning tab with shift templates and shift calendar
Maintain shifts and availability plans

The Planning tab is where you generate the actual shifts. Under Create Weekly Plan you pick a time period and a Monday-to-Sunday pattern, setting the shifts for each day. Existing entries in that period are replaced.

The Calendar View below shows the result week by week with concrete times, such as 06:00 - 14:00. Individual shifts are edited there.

The former standalone shift planner has been folded into this tab.

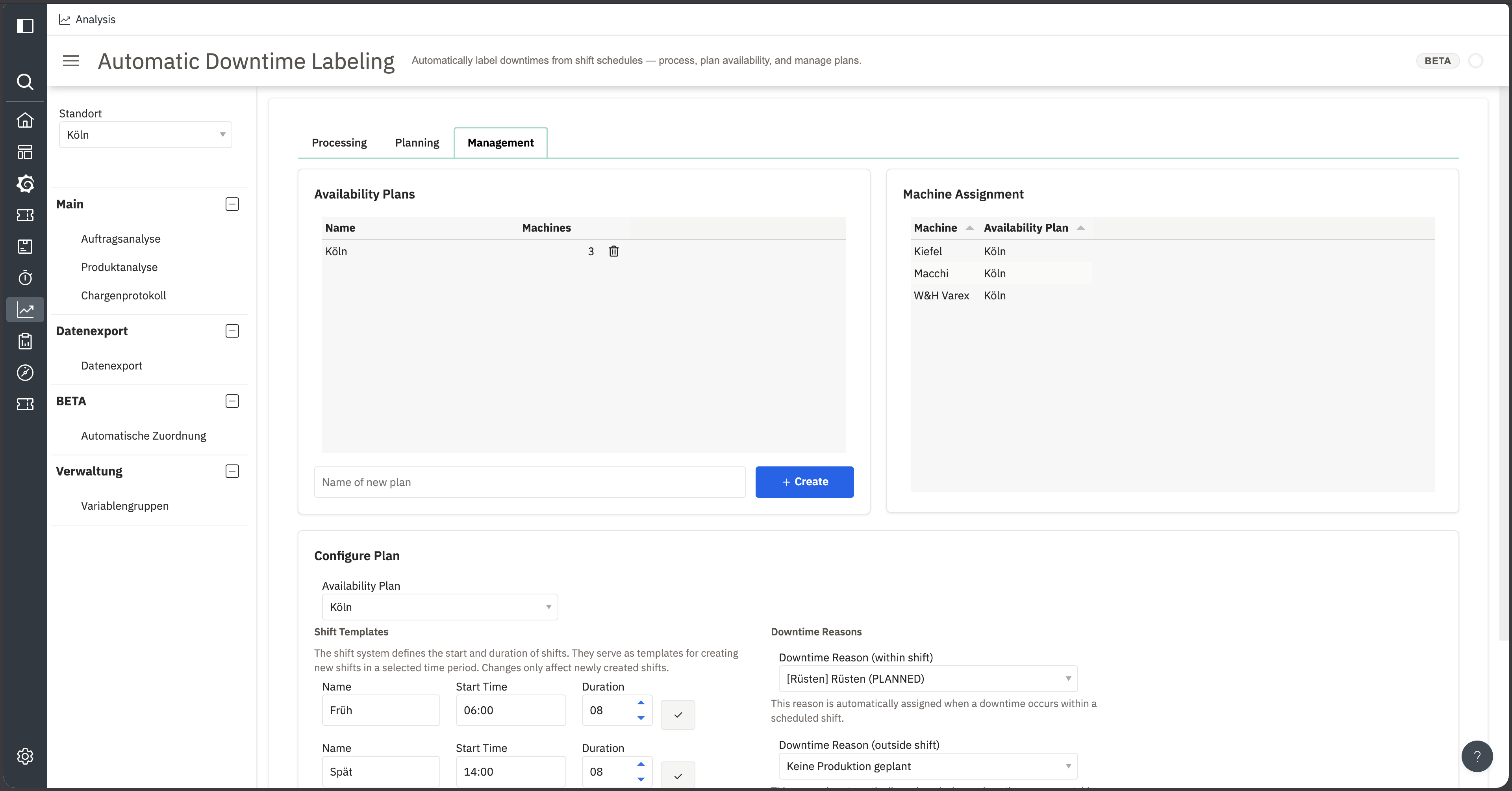

Management

Management tab with per-machine assignment rules
Set per machine which assignment types apply and with which default reasons

The tab has three areas:

  • Availability Plans: the existing plans with the number of machines assigned. The name field below creates a new one.

  • Machine Assignment: which machine follows which plan.

  • Configure Plan: the selected plan's Shift Templates, each with a name, start time and duration in hours. Templates only define how new shifts are created; changes do not affect shifts already created. Beside them sit the Downtime Reasons: one default for inside a shift and one for outside, each showing its category in brackets, for example [Setup] Setup (PLANNED).

A machine with no plan assigned shows as Not configured in the Processing tab.

Common questions

A machine shows as not configured. What is missing?

Check the Downtime Detection and Machine Parameter columns in the same row. A red cross shows which part is missing. ENLYZE sets up downtime detection and machine-parameter rules; you create availability plans and assign machines in the Management tab.

Can I undo an assignment?

Not from this dashboard. Correct individual downtimes in the ENLYZE app, see Assigning reasons to downtimes. To stop a later pass overwriting your correction, delete the Automatically assigned ... comment on the downtime.

Does processing change OEE retroactively?

Yes. Whether downtime time is OEE-relevant is decided by the category of the assigned reason, so the metrics for the processed range change.

The reasons themselves are useful beyond that: in the app's downtime report, and for questions like which unplanned faults occur most often.

Last updated
